Project
Effective project budget management requires detailed monthly and annual cost analysis. You can track spending for capital projects by jobs and activities with QAD EAM project reports.
Cost Analysis

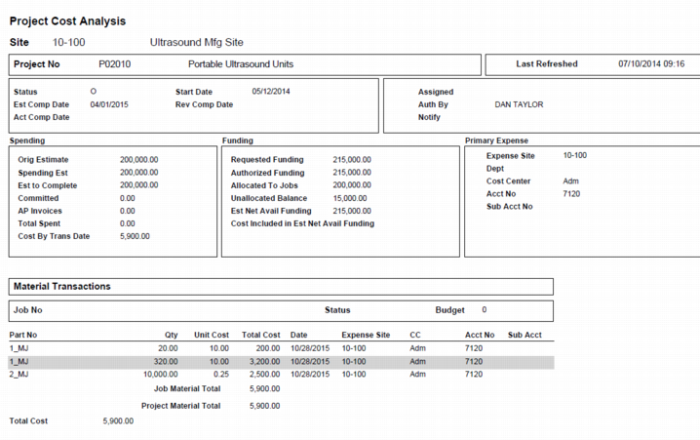

Project Cost Analysis
This report displays the total cost of manual GL transactions, labor transactions by employee number, material transactions by part number, and contractor transactions by part number.

Project Cost Analysis Report

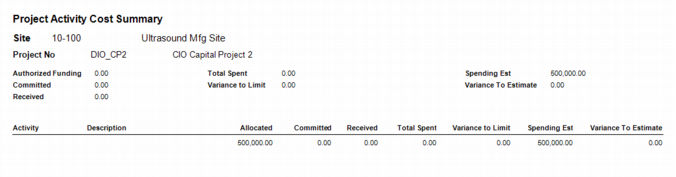

Project Activity
The Project Activity Report calculates the subtotal of all amounts by Activity and Project values. It displays the following columns:
Activity
Activity Description
Committed
Received
Spending Limit
Variance to Limit = If Spending Limit <> 0, then (Committed+Total Spent)/Spending Limit. Otherwise, it displays 0.
Spending Estimate
Variance to Estimate = If Spending Estimate <> 0, then (Committed+Total Spent)/Spending Estimate. Otherwise, it displays 0.
Spending Estimate

Project Activity Report

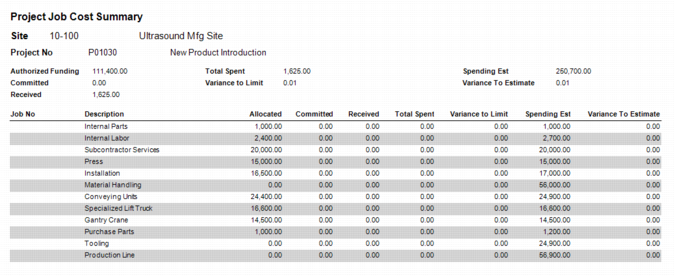

Project Job Cost
This report calculates the project job cost through the subtotal amounts by Job No and Project. It displays the planned, committed and total spent values, both at their lowest level and rolled up into the total amount. The report also displays the percent variance of total spent compared to either the limit or estimate, but those variances can only be calculated when limits and estimates are available. Project totals cannot be calculated, but are pulled from the project table.
It displays the following columns:
Job No
Job Description
Committed
Received
Spending Limit
Variance to Limit = If Spending Limit <> 0, then (Committed+Total Spent)/Spending Limit. Otherwise, it displays 0.
Spending Estimate
Variance to Estimate = If Spending Estimate <> 0, then (Committed+Total Spent)/Spending Estimate. Otherwise, it displays 0.
Spending Estimate

Project Job Cost Report

Project Reimbursement Due

Project Reimbursement Due Report

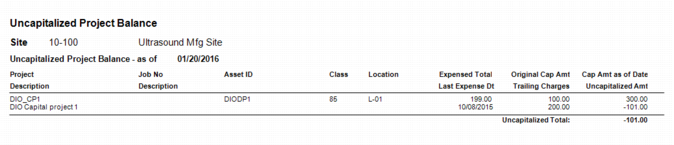

Uncapitalized Project Balance

Uncapitalized Project Balance Report

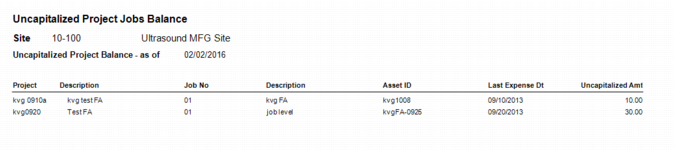

Uncapitalized Project Jobs Balance

Uncapitalized Project Jobs Balance Report
